Latest Nuclear Jobs

View all 1,669 jobs

LaSalle County Station is located near:

Nuclear NewsNEW This month in Oak RidgeOctober Energycast; 2027 Cleanup Priorities; Waste Management Upgrades; and more Crews at the Oak Ridge Reservation completed major infrastructure upgrades and demolished ten legacy buildings during fiscal year 2026 while logging over 1.3 million safe work hours. Operators also installed a smartphone-based remote monitoring system at the Environmental Management Waste Management Facility to track landfill wastewater. These projects reduce environmental risks and support ongoing research missions at the federal site.
Nuclear NewsNEW Hitachi’s nuclear revenue rises as SMR delivery date approachesHitachi reported a forty-eight percent year-over-year increase in its nuclear division revenue during the latest quarter. The growth aligns with preparations to deliver the first of four BWRX-300 small modular reactors to Ontario Power Generation by 2030. Additional deployments are scheduled for the Tennessee Valley Authority by 2032.
Nuclear NewsNEW Walsh, industry reps discuss “American energy hub” at Oak Ridge cleanup siteDepartment of Energy officials and private nuclear executives met at the former Oak Ridge Gaseous Diffusion Plant in Tennessee. The gathering highlighted over fifteen billion dollars in ongoing commercial projects spanning fuel fabrication, enrichment, and advanced reactor development on remediated federal land.
Nuclear NewsNEW Curtiss-Wright Invests $30M to Expand Nuclear Instrumentation Manufacturing in TexasCurtiss-Wright Corporation is allocating thirty million dollars to enlarge its Round Rock operations in Texas. The project boosts production capacity for pressure and temperature sensors, radiation monitoring systems, and other instrumentation utilized in nuclear energy facilities.
Nuclear NewsNEW Centrus Begins Shipping Centrifuges to Ohio to Support Major Expansion of Uranium Enrichment CapacitCentrus Energy has completed and shipped the first newly manufactured uranium enrichment centrifuge from its facility in Oak Ridge, Tennessee. The hardware is bound for the company site in Piketon, Ohio. This delivery represents the initial tangible output of a domestic manufacturing restart intended to scale up domestic fuel production.
Nuclear NewsNEW Yucca Mtn. clause, now blocking nuclear campus program, could be removed in lame duck: Fleischmann sRep. Chuck Fleischmann aims to remove the legal designation of Yucca Mountain as the sole nuclear waste repository during the upcoming congressional lame duck session. Repealing this restriction would allow the Department of Energy to advance its Nuclear Lifecycle Innovation Campus program in willing states. The proposed legislative changes would also encourage commercial spent nuclear fuel reprocessing.
Nuclear NewsNEW How D.C. Cook built a culture of excellence and continuous improvementThe D.C. Cook nuclear plant received the Utilities Service Alliance Optimizer Award for the second consecutive year. Station leaders accepted the honor at the annual executive summit following a multi-year overhaul of their supply chain operations, warehouse organization, and vendor management practices.
Nuclear NewsNEW US microreactor secures first-of-its-kind DOE approval for full-power operationsUS clears safety hurdle for extended nuclear microreactor testing Radiant has received Department of Energy approval for the Documented Safety Analysis of its Kaleidos microreactor at Idaho National Laboratory. The decision allows the company to pursue a five-phase testing campaign targeting 60 days of full-power operation. The results will provide critical operational data for the 1-megawatt transportable design ahead of planned commercial deliveries to military installations.
Nuclear NewsNEW Federal agency accepts license application for General Matter’s uranium enrichment operation in McCrThe U.S. Nuclear Regulatory Commission has accepted the license application for a planned uranium enrichment facility in McCracken County, Kentucky. General Matter intends to construct the commercial plant on a parcel at the former Paducah Gaseous Diffusion Plant site, targeting full operations by 2029.
Nuclear NewsNEW DOE’s ARPA-E selects eight transuranic fuel development projectsThe Department of Energy selected eight research projects to receive up to $50 million through the HORNIG program. The awards fund the development of advanced reactor fuels using recycled transuranic waste elements derived from weapons production and used nuclear fuel inventories.
Nuclear NewsNEW Idaho State University, Idaho National Laboratory Researchers Drive Innovation in Advanced Nuclear RResearchers from Idaho State University and Idaho National Laboratory are developing prefabricated Layered Composite walls with Mechanical Connections to accelerate nuclear facility construction. Funded by a 1.6 million dollar grant, the project aims to reduce build times for advanced reactors while maintaining structural integrity and radiation shielding standards.
Nuclear NewsNEW Watchdogs raise alarms about fire at South Carolina site where US plans to build nuclear componentNuclear watchdogs raise alarms about fire at South Carolina lab | AP News Nuclear watchdog groups are demanding details following a fire at a national laboratory in South Carolina. The incident prompted a site area emergency declaration, airspace closures, and employee sheltering at the facility. Federal officials reported no radiological release or contamination occurred during the event.

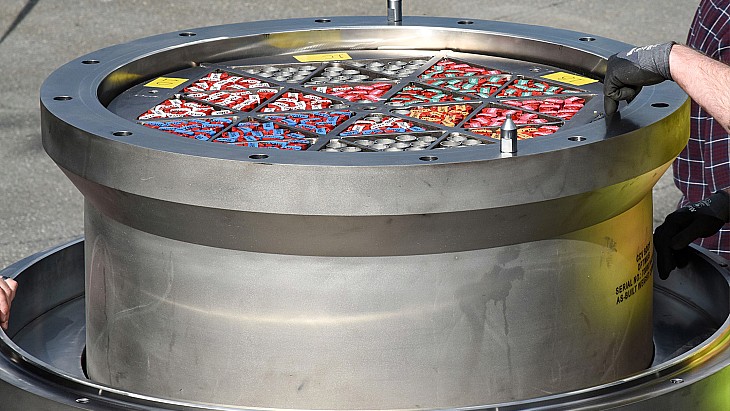

Nuclear NewsNEW Antares, BWXT in TRISO fuel procurement dealAntares Nuclear has contracted BWXT Advanced Fuels to provide an initial tonne of high-assay low-enriched uranium TRISO fuel. The material will be fabricated in Virginia to power upcoming microreactors, including the Mark-1 electricity-producing unit. This agreement secures a domestic fabrication source for the advanced reactor developer as it prepares for commercial deployment.
Nuclear NewsNEW Fusion companies sign LOIs for federal R&D awardsFusion companies sign LOIs for federal R&D awards The Department of Commerce signed letters of intent to award federal funding under the CHIPS and Science Act to fusion developers Helion and Commonwealth Fusion Systems. Helion is slated to receive up to $175 million for power semiconductor research, while Commonwealth Fusion Systems is eligible for up to $85 million for plasma heating and diagnostics electronics. In exchange, the federal agency will secure non-voting equity stakes in the companies.
Nuclear NewsNEW Levin unveils strategy to relocate spent fuel at San Onofre nuclear plantRepresentative Mike Levin released a legislative strategy to relocate 3.6 million pounds of spent nuclear fuel stored at the decommissioned San Onofre plant. The proposal involves establishing regional innovation campuses that accept nuclear waste and utilizing the newly certified Atlas Railcar System for transport. While plant owner Southern California Edison maintains the coastal storage can withstand environmental threats for decades, permanent federal disposal solutions remain stalled.
Nuclear NewsNEW Levin unveils strategy to relocate spent fuel at San Onofre nuclear plantRepresentative Mike Levin released a legislative strategy to relocate 3.6 million pounds of spent nuclear fuel currently stored at the decommissioned San Onofre site. The proposal introduces regional Nuclear Lifecycle Innovation Campuses to handle fuel processing and encourages host states to store waste. It also relies on the newly certified Atlas Railcar System for secure transport, addressing long-term coastal erosion concerns raised by local officials.
Nuclear NewsNEW From the Periodic Table to New Nuclear Energy MaterialsResearchers at Pacific Northwest National Laboratory developed a computational method called robust alloy design to identify new materials for advanced reactors. The team used this system to create and test an experimental alloy named V555, which demonstrated strong initial mechanical properties in laboratory evaluations.
Nuclear NewsNEW Savannah River Site ends area emergency after lab fireOfficials at the Savannah River Site terminated an emergency declaration following a laboratory fire that caused an unfiltered radiological release. One worker sustained minor injuries and was hospitalized, while surrounding areas experienced temporary shelter-in-place orders and traffic restrictions.
Nuclear NewsNEW EM UpdateEM Leadership Surveys Portsmouth Cleanup Progress, Paving Way for Reindustrialization and Energy Future; Hanford’s Tank Side Treatment System Sets New Record, and much more! Department of Energy officials recently toured the Portsmouth Site to review demolition progress while Hanford workers processed a record volume of radioactive waste through their cesium removal system. Meanwhile, Los Alamos representatives updated local stakeholders on increased waste shipments to the Waste Isolation Pilot Plant.
Nuclear NewsNEW How an $85M federal award would help CFS, fusion energy, and U.S. chip industryThe Department of Commerce and Commonwealth Fusion Systems signed a letter of intent for an $85 million federal award under the CHIPS and Science Act. The funding will support microelectronics projects, including power supplies and controllers, to benefit both domestic semiconductor manufacturing and fusion reactor development. This initiative aims to strengthen the supply chain for commercial fusion power plants such as SPARC.

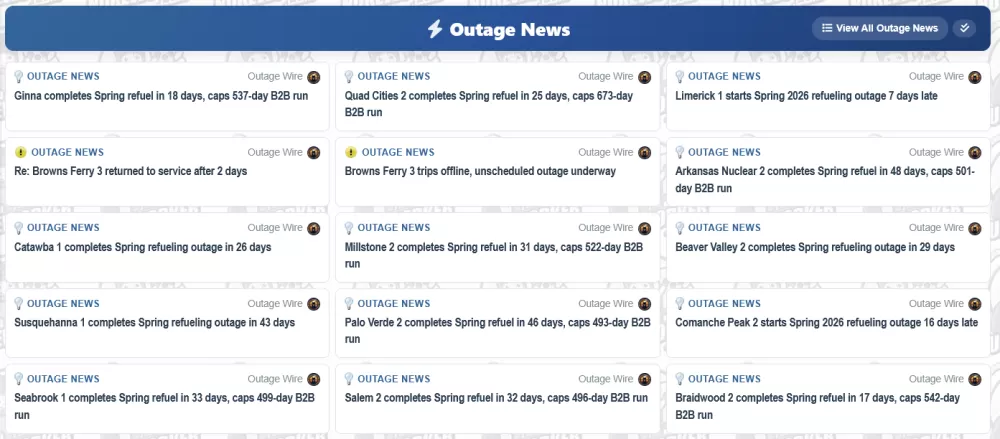

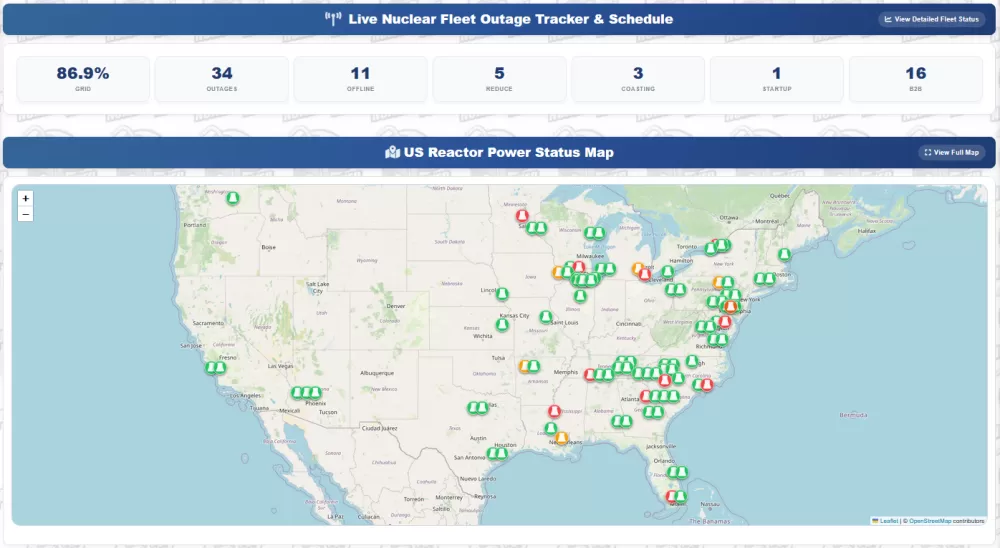

Outage NewsNEW Byron 2 begins Fall 2026 refueling outageByron Unit 2 began a scheduled refueling outage on September 28, 2026, starting precisely on its planned date. The 1,136-MW Westinghouse four-loop pressurized water reactor entered the fall maintenance period following a 3637-day unscheduled-outage-free streak.
Outage NewsNEW Byron 2 completes Fall refuel in 27 days, caps 514-day B2B runThe Byron 2 routine refueling outage ran 6 days longer than the planned 21 days, totaling 27 days at 0% power. The 27 day duration ranks as the third-longest among the unit's 19 tracked refuels, following an outage period from Sep 28, 2026 to Oct 24, 2026. The unit returned to full power at 100% as of the NRC report of Oct 29, 2026, entering the refuel with more than 9 years without an unscheduled outage.
Outage NewsNEW Vogtle 2 begins Fall 2026 refueling outageGeorgia Power began a routine refueling outage at Vogtle 2 on September 13, 2026. The 1,152-MW Westinghouse pressurized water reactor entered the maintenance window exactly on its scheduled start date with a planned 43-day duration.
Outage NewsNEW D.C. Cook 1 begins Fall 2026 refueling outageIndiana Michigan Power began a routine refueling outage at D.C. Cook 1 on 2026-09-19. The 1,009-MW Westinghouse 4-loop PWR started the maintenance period on the planned date with a scheduled duration of 32 days.
Outage NewsNEW Vogtle 2 completes Fall refuel in 40 days, caps 529-day B2B runVogtle 2 finished its routine refueling outage 3 days early, completing the work in 40 days instead of the planned 43 days during the fall season. By the NRC report of Oct 26, 2026, the unit was back at full power of 98%. The 40 day duration ranks as the third-longest among the unit's 19 tracked refuels, running 12 days above the average of 28 days for 18 prior refuels.
Outage NewsNEW Dresden 3 begins Fall 2026 refueling outageDresden 3 began a routine refueling outage on Oct 26, 2026, starting 1 day earlier than planned. The fall outage commenced after the unit had run about 98% of its typical 724-day operating cycle. Historically, the unit maintains a 19.9-day average across 14 prior refuels, with its longest prior refuel reaching 40 days in 2004.
Outage NewsD.C. Cook 1 completes Fall refuel in 33 days, caps 507-day B2B runD.C. Cook 1 completed a routine refueling outage lasting 33 days, running 1 day longer than the planned 32 days. The outage period spanned from Sep 19, 2026 to Oct 21, 2026 at 0% power. As of the NRC report of Oct 22, 2026, the unit restarted and was at 12% power while still ramping up.
Outage NewsWaterford 3 begins Fall 2026 refueling outageWaterford 3 began its routine refueling outage on Oct 17, 2026, right on its scheduled start date with a planned duration of 25 days. The unit entered this fall outage following a streak of about 23 months without an unscheduled outage, having run about 89% of its typical 561-day operating cycle. Its 18 prior refuels averaged 49.9 days.
Outage NewsSusquehanna 1 trips offline, unscheduled outage underwaySusquehanna 1 began a forced short unscheduled outage on September 29, 2026. The event ended the 1,247-MW General Electric BWR/4 unit's unscheduled outage-free streak at 317 days.
Outage NewsFarley 2 begins Fall 2026 refueling outageFarley 2 began a routine refueling outage on Oct 19, 2026, 1 day later than the scheduled start date of Oct 18, 2026. The outage has a scheduled duration of 27 days. Prior to this event, the unit had run for about 16 months without an unscheduled outage and completed about 91% of its typical 548-day operating cycle.
Outage NewsComanche Peak 1 begins Fall 2026 refueling outageComanche Peak 1 began a routine refueling outage on Oct 19, 2026, starting 1 day later than the scheduled Oct 18, 2026 date. The published schedule anticipates a duration of 32 days for the fall outage. Going into this refuel, the unit had gone about 13 months without an unscheduled outage and had run about 95% of its typical 549-day operating cycle.
Outage NewsHatch 1 trips offline, unscheduled outage underwayHatch 1 began an unscheduled forced short outage on October 11, 2026. The event ended a 167 day unscheduled outage free streak for the unit, with duration projected at about four days.
Outage NewsPeach Bottom 2 begins Fall 2026 refueling outagePeach Bottom 2 began a routine refueling outage on October 12, 2026, matching its published schedule. The 1,265-MW boiling water reactor entered the maintenance period following an unscheduled-outage-free streak of 823 days.
Outage NewsMillstone 3 begins Fall 2026 refueling outageDominion Energy Nuclear Conn began a routine refueling outage at Millstone 3 on October 12, 2026, starting one day later than its scheduled October 11 start date. The Westinghouse four-loop pressurized water reactor entered this maintenance period following an unscheduled outage-free streak of 351 days.
Site NewsNEW Radiation Instrument Index, 193 Meters with Specs & ManualsThe Radiation Instrument Index just grew: replies did this. The page now has 193 instruments, up from 129, and 128 of them have the manual on file, up from 66. You Asked, It's There RDS-32 and the Tele-STTC-2: the RDS-32 and its wide range telescoping probe are on the page, with Mirion's specs and the RDS-32 user manual. ISOCS and HPGe: search HPGe or specific activity and ISOCS comes up, along with the BEGe and GEM germanium detectors. 64 New Instruments Friskers and probes: Ludlum 177, 2401-P, 2224-1, 44-10, 44-3, 43-1, 44-7 and the 239-1F floor monitor, Eberline E-140, E-600 and ESP-1, Canb...
History & TriviaHow Close Were the Nazis to a Nuclear Bomb?During World War II, Nazi Germany and the United States pursued rival nuclear weapons programs. While the American Manhattan Project succeeded, the German project failed to build a functioning nuclear reactor or weapon due to severe resource shortages and technical hurdles. Historical analysis and recent scientific studies show that the German team lacked sufficient uranium and pure heavy water to sustain a chain reaction. This historical divergence highlights how industrial scale, material purity, and centralized resources dictate the success of nuclear development efforts. Behind the lines o...

Site NewsNew: RCT Part 2 Practice Test, NRRPT & CHP Additions, & More Free TriviaWe are very excited to announce that the NukeWorker Quiz now includes the DOE RCT Core Part 2: Site Academics , all 19 modules: completes the DOE RCT Core. Part 1, Part 2 and a Comprehensive Examination over both Part 1 & 2 are all in the quiz now, 48 practice tests drawing from 1,819 questions. New: RCT Core Site Academics (DOE Part 2) 19 module quizzes: RCT Core 2.01 Radiological Documentation through 2.19 Counting Room Equipment. Dosimetry, contamination control, respiratory protection, source control, work coverage, shipments, incidents, decon, first aid and the instrument modules are all...
Site NewsNew in the Practice Tests: Study Help for the Questions You MissMissed a question on one of our practice tests? Now the answer sheet tells you exactly where to go study it.When you finish a NukeWorker practice test, the answer sheet shows each question, the answer you picked, and the correct answer. Now most questions also have a Study Help box. It points you to the book, chapter and objective that cover that question.For example, if you miss an alpha monitoring question on the NUF practice exam, Study Help sends you to NUF Cram Notes, Chapter 8, Objective 8.2 . Open the book, go straight to that objective, and you’re studying the exact material the questi...
History & TriviaThe 1946 Law That Put America’s Atomic Bombs Under Civilian ControlThe 1946 Law That Put Atomic Bombs Under Civilian Control | HISTORY The U.S. faced an unprecedented question after World War II: Should civilians or the military oversee its nuclear ars... All the major chapters in the American story, from Indigenous beginnings to the present day. History from countries and communities across the globe, including the world’s major wars. From prehistory, though antiquity and into the 21st century, all of history’s biggest chapters. Read the full article at HISTORY :

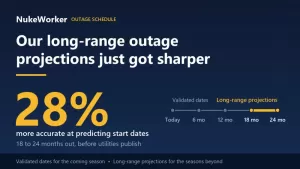

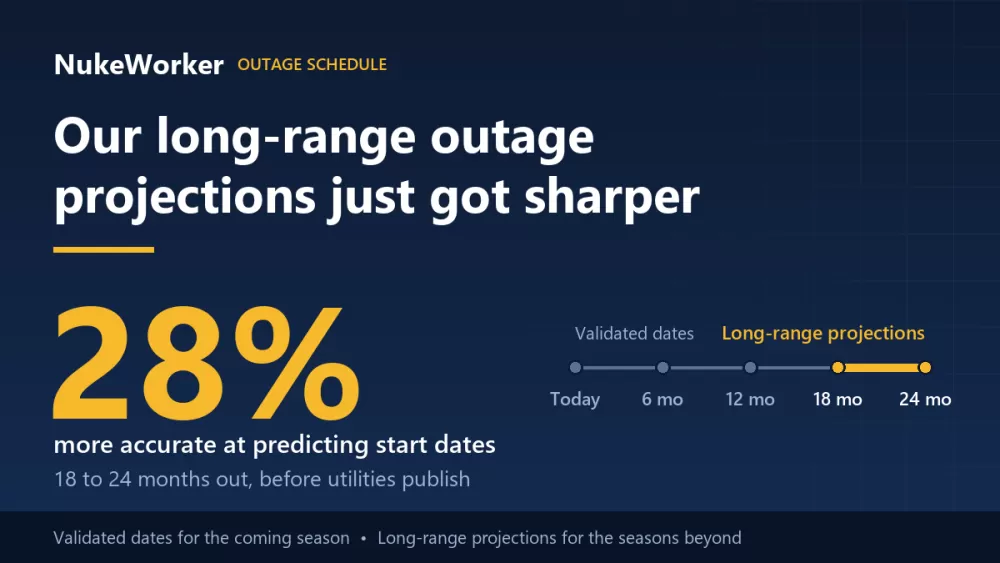

Site NewsOur long-range outage projections just got sharperNukeWorker's Outage Schedule gives you two things: validated dates for the coming season, and our own long-range projections for the seasons beyond, 18 to 24 months out, before the utilities publish their dates.Today we upgraded the engine behind those long-range projections. Measured against the dates utilities have since confirmed, the new engine is 28% better at predicting long-range (18 to 24 month) start dates.See how we score ourselves on the Accuracy Scorecard.
